Measuring a Trench with Changing Width and Depth

Measure a variable trench with station sections, end-area formulas, worked examples, curve checks, and a traceable field record.

An unoccupied trench with changing sections, surface survey stakes, a laser level, measuring tape, and a protected deep segment.
Place measurement stations at meaningful geometry and alignment changes, then keep every adjacent section connected in the quantity record.

A trench route can change at a service crossing, grade break, structure, bend, or different excavation detail. Record those changes at named stations, calculate the excavation area at each station, and total the volume between adjacent sections.

How do you measure a trench when width and depth change?

Divide the route at every meaningful change and assign a station to each boundary. Measure or obtain the excavation cross-section at each station, calculate its area, then use the approved volume method between adjacent sections.

Keep one continuous station record.

Each segment should end at the same station where the next segment begins. This prevents gaps, overlaps, and untraceable averages.

The Trench Excavation Calculator handles uniform rectangular sections. Use the station method on this page when the end areas differ or when the project requires cross-section quantities.

Where should trench measurement stations go?

Place a station at the start and end of the measured route. Add another station wherever the excavation boundary, alignment, formation, structure, material zone, or measurement rule changes.

  • Start and end of the trench run.
  • Ground or formation grade break.
  • Change in bottom width, top width, side geometry, or depth.
  • Bend, junction, branch, chamber, pit, crossing, or widened connection.
  • Change in shoring, shielding, sloping, benching, or other approved excavation detail.
  • Boundary between materials, work items, pay limits, or survey surfaces.
  • Location where a midpoint check shows that the end sections do not represent the shape between them.

There is no universal station interval. The FHWA OpenRoads quantity manual explains that average end-area accuracy depends on how often sections are analysed and that an important feature between sections can be missed. Follow the governing drawings, survey plan, tolerance, contract method, and responsible survey or engineering direction.

What should you record at every station?

Use one alignment reference and one unit system. Record the station identifier, source, excavation boundary, cross-section shape, and calculated area before moving to the next segment.

Trench station measurement record
FieldRecordWhy it matters
StationChainage, station, offset, or named field referenceConnects the section to the route
SourceDrawing, design model, pre-excavation survey, as-built survey, or approved field changeIdentifies what the quantity represents
AlignmentReference line and section orientationControls segment length and curve treatment
Bottom and top limitsWidths, offsets, elevations, and approved side geometryDefines the excavation area

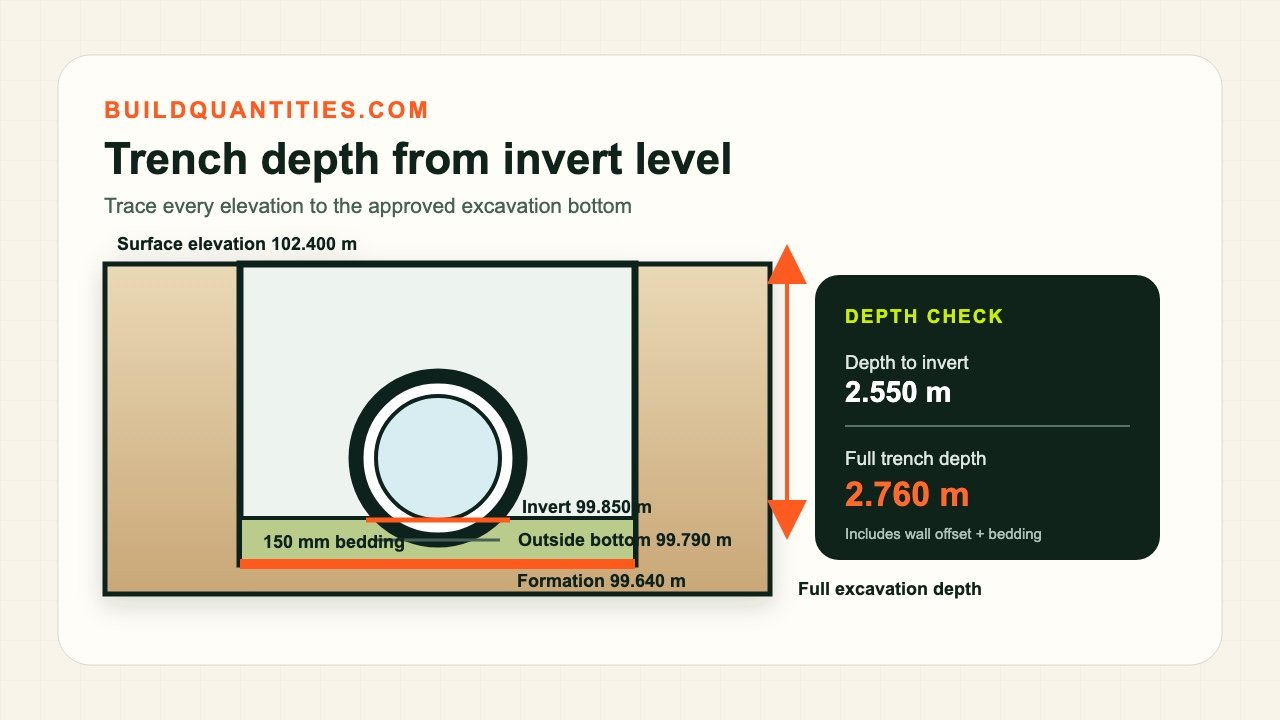

DepthVertical difference between the stated surfacesPrevents slope length from replacing vertical depth
AreaCalculated or surveyed cross-sectional area with unitFeeds the volume formula
StatusDesign, tender, revised, actual, or payment recordKeeps unlike quantities separate

Collect actual-excavation measurements through the project's safe survey method. Do not enter an unsupported or hazardous trench to obtain a quantity reading.

How do you calculate a rectangular or trapezoidal end area?

A rectangular section uses one excavation width and vertical depth. A trapezoidal section uses parallel top and bottom widths with a stated vertical depth.

Rectangular end area = excavation width × vertical depth

Trapezoidal end area = (top width + bottom width) ÷ 2 × vertical depth

Use these formulas only when the measured shape matches them. A benched, asymmetric, curved, shored, or irregular section may need coordinates, component areas, a survey surface, or the governing design model.

Do not average width and depth across an abrupt change

Multiplying one route-wide average width by one route-wide average depth can hide where the wide and deep portions occur together. Calculate the area at each station first. The end-area method then combines adjacent areas over a known distance.

What is the average end-area formula?

The average end-area method averages the cross-sectional areas at 2 adjacent stations and multiplies that average by the distance between them. Iowa DOT defines the method as:

Segment volume = length × (start area + end area) ÷ 2

Use compatible units. Metres multiplied by square metres produce cubic metres. Feet multiplied by square feet produce cubic feet, which can be divided by 27 to obtain cubic yards.

Worked metric example with changing width and depth

Two rectangular station sections are 12 m apart. At the first station, the trench is 0.75 m wide and 1.20 m deep. At the second, it is 0.90 m wide and 1.50 m deep.

  1. Start area: 0.75 × 1.20 = 0.90 m².
  2. End area: 0.90 × 1.50 = 1.35 m².
  3. Average area: (0.90 + 1.35) ÷ 2 = 1.125 m².
  4. Segment volume: 12 × 1.125 = 13.50 m³.

The result represents the stated excavation boundary between those stations under the average end-area method. It does not add swell, over-excavation, backfill, or supplier rounding.

When should you check the prismoidal formula?

Use a representative midpoint area when the project method calls for a prismoidal calculation or when you need to test whether the 2 end areas describe the shape between them. Iowa DOT gives the formula:

Prismoidal volume = length × (start area + 4 × midpoint area + end area) ÷ 6

For the 12 m example, assume a measured midpoint section of 0.82 m × 1.31 m. Its area is 1.0742 m².

  1. Multiply the midpoint area by 4: 4 × 1.0742 = 4.2968 m².
  2. Add the 3 weighted areas: 0.90 + 4.2968 + 1.35 = 6.5468 m².
  3. Multiply by 12 ÷ 6: 2 × 6.5468 = 13.0936 m³.

The average end-area result is 13.50 m³, while the prismoidal result is 13.0936 m³. The difference is 0.4064 m³, about 3.10% of the prismoidal result. The midpoint shows that the section did not grow in the exact pattern implied by the 2-end average.

Do not choose the lower or higher answer because it suits the estimate. Use the method required by the project and improve the measurement data when the difference matters.

How do you calculate trapezoidal sections in cubic yards?

Calculate each trapezoidal end area first, then apply the average end-area formula. Assume 2 sections are 20 ft apart.

Trapezoidal trench end-area example
StationBottom widthTop widthDepthArea
0+002.0 ft4.0 ft3.0 ft9.0 ft²
0+202.5 ft5.5 ft4.0 ft16.0 ft²
  1. Average the areas: (9 + 16) ÷ 2 = 12.5 ft².

  2. Multiply by length: 12.5 × 20 = 250 ft³.
  3. Convert to cubic yards: 250 ÷ 27 = 9.259 yd³.

The top and bottom widths in this example define geometry only. They do not select an excavation protective system. Use the approved project and safety process to establish the actual cross-section.

How do you total several trench segments?

Carry the end area at each shared station into the next segment. Add the unrounded segment volumes, then round the final in-place total at the precision required by the record.

Connected trench station example
SegmentLengthStart areaEnd areaVolume
0+00 to 0+2020 ft8 ft²10 ft²180 ft³
0+20 to 0+4525 ft10 ft²14 ft²300 ft³
Total45 ft3 connected stations480 ft³, or 17.778 yd³

The shared 10 ft² area at station 0+20 closes the first segment and opens the second. If the 2 records show different areas at the same station, resolve the revision, boundary, or transcription error before totalling.

How should bends and curved trenches be measured?

Measure segment length along the stated reference alignment and place sections normal to that alignment unless the governing survey method specifies another orientation. Add a station at a sharp bend rather than drawing one end area across the corner.

The USACE Plans Preparation Manual warns that wide cross-section intervals on curves or changing alignment angles can skew comparative sections and misrepresent the distances used in average end-area calculations. Shorter intervals can help, but the project survey method controls the required treatment.

Keep branches and structures separate

Calculate a branch from its own junction station. Treat chambers, manholes, thrust blocks, pits, widened joints, and other compact excavations as separate shapes or surveyed volumes. Subtract an overlap once when 2 excavation volumes occupy the same space.

When is a surface model better than end areas?

Use the project's approved surface or solid model when the trench has irregular walls, many bends, dense survey data, overlapping excavations, or changes that a small set of sections cannot represent. A triangulated surface method compares the applicable surfaces throughout their shared extent.

FHWA notes that average end-area calculations ignore the model between the selected cross sections. USACE also states that the accuracy and density of the surface data control triangulated results. Software output still needs boundary, unit, revision, and hand-check verification.

Which trench quantity are you measuring?

Name the quantity before comparing totals. Similar-looking cubic-yard or cubic-metre figures can describe different boundaries and project stages.

Trench quantities that require separate records
QuantityBoundary or stateControl source
Design or neat-line volumeExcavation lines and grades shown by the approved designDrawings, model, specification, and revisions
Estimated construction volumePlanned excavation method and approved geometryMethod, temporary works, field constraints, and estimate basis
Actual excavated volumeSurveyed pre-excavation and post-excavation surfaces or sectionsApproved survey and measurement procedure
Payment quantityMeasured or theoretical boundary allowed by the contractContract measurement and pay provisions

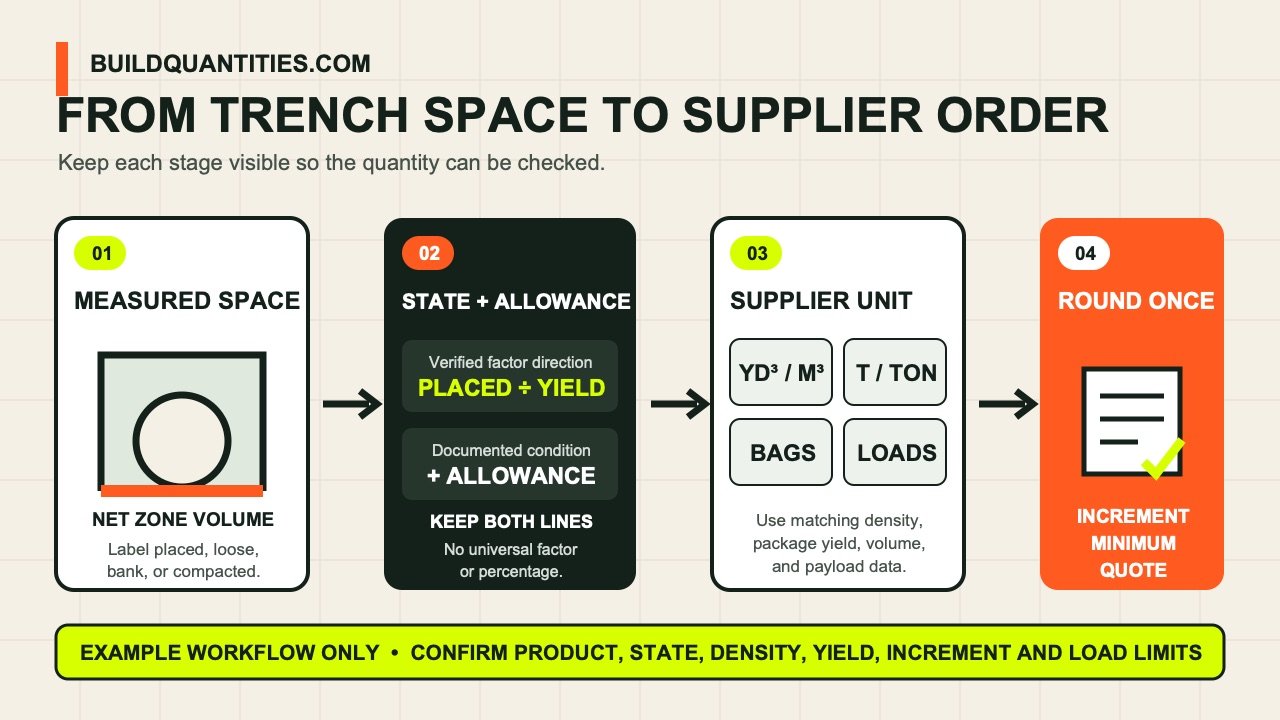

Loose spoil volumeExcavated material after disturbanceMaterial-specific state conversion or direct measurement
Backfill volumeAccepted fill zones after subtracting permanent components where requiredProject details, materials, placement, and testing rules

Do not apply a swell factor to cross-section dimensions. Calculate the in-place excavation volume first, then convert that total to a loose state with project-specific evidence when haul or stockpile planning needs it.

Build a checkable trench quantity sheet

  • Project, route, drawing, model, and revision identifiers.
  • Measurement purpose: design, estimate, actual, payment, or another stated basis.
  • Alignment, station direction, datum, units, and section orientation.
  • Start, midpoint when used, and end cross-section measurements.
  • Shape formula or surveyed area for each station.
  • Distance, volume method, and unrounded result for each segment.
  • Reason for every added or omitted station.
  • Separate line for overlaps, structures, exclusions, and approved changes.
  • Final in-place total before material-state or commercial adjustments.
  • Prepared date, checker, unresolved assumptions, and source links.

Measure from a safe position

Quantity work does not authorize trench entry. Use plans, models, remote survey equipment, surface observations, or another approved method that fits the project safety plan.

For U.S. construction work, OSHA identifies cave-ins as the main trench hazard. OSHA 29 CFR 1926.651 also covers underground installations, access and egress, hazardous atmospheres, water accumulation, adjacent structures, loose material, and competent-person inspections. Other countries use their own workplace rules.

The quantity method does not design sloping, benching, shoring, shielding, access, dewatering, or traffic control. Those decisions come from the applicable rules, site conditions, project documents, and responsible competent or qualified people.

Common variable-trench measurement mistakes

  • Using one route-wide average width and depth across abrupt changes.
  • Skipping a station at a bend, junction, structure, or grade break.
  • Mixing a design section with an actual excavation section in one segment.
  • Measuring a sloped side length as vertical depth.
  • Applying the rectangle formula to a trapezoidal, benched, or irregular section.
  • Using cross-section intervals that miss an important feature between stations.
  • Letting sections become skewed on a curve without checking the alignment method.
  • Rounding every end area or segment before adding the total.
  • Applying swell, over-excavation, and payment rules to the same number without separate records.
  • Treating software output as checked without reviewing the boundary, units, revision, and a hand fixture.

Sources and scope

Scope: this page explains quantity measurement for a changing trench. The governing drawings, survey procedure, contract, measurement and payment rules, safety plan, temporary-works design, applicable law, and responsible qualified people control the final geometry, method, tolerances, protective systems, construction, and accepted quantity.
